Breakdown Maintenance in Plants: Meaning, Types, Examples and Procedure

Quick answer

Breakdown maintenance is repair work carried out after equipment has failed or stopped performing as required. It can be planned, where a plant decides to run selected non-critical assets until they fail, or unplanned, where critical equipment stops without warning and needs an emergency response. Used selectively, it can be cost-effective. Relied on across critical equipment, it increases downtime, repair costs and production losses.

Key takeaways
  • Planned breakdown maintenance is a decision. Unplanned breakdown maintenance is an emergency. Run-to-failure can suit selected non-critical assets. Emergency work happens when important equipment stops without warning.
  • Breakdown maintenance is right for some equipment. Low-value, readily replaceable equipment with minimal production impact can be run to failure. It should never be used where failure creates a safety, environmental or legal risk.
  • The cost is rarely just the repair. Lost production, idle labour, rush freight and overtime usually cost more than the part that failed.
  • A written procedure saves hours. A clear seven-step routine, spares on the shelf and trained technicians decide whether a failure costs two hours or two days.
  • Repeat failures are a signal, not bad luck. The same machine failing three times means the root cause was never found. A simple breakdown report and a 5 Whys review usually find it.
  • Most plants run a mix. Breakdown maintenance on low-value assets, preventive maintenance on critical equipment. The skill is knowing which is which.

Breakdown maintenance has a bad reputation. It is treated as the thing you do when you have failed to plan.

That is only half true.

Every plant runs some equipment to failure on purpose. A ₹4,000 pump with a spare on the shelf does not need a maintenance schedule. Servicing it costs more than replacing it.

The problem starts when breakdown maintenance becomes the default rather than a decision.

This guide covers the types of breakdown maintenance, real plant examples, a seven-step breakdown procedure, a report format you can use, when running to failure makes sense, and what failures actually cost.

What is breakdown maintenance?

Breakdown maintenance is repair work carried out after equipment has stopped working.

In simple terms, it is carried out when a machine has failed and can no longer do its job.

No schedule. No inspection interval. The machine runs until something fails, then it gets fixed.

It is often grouped with reactive maintenance, but the two terms are not exactly the same. We explain the difference later in this guide.

The important question is whether the failure was expected.

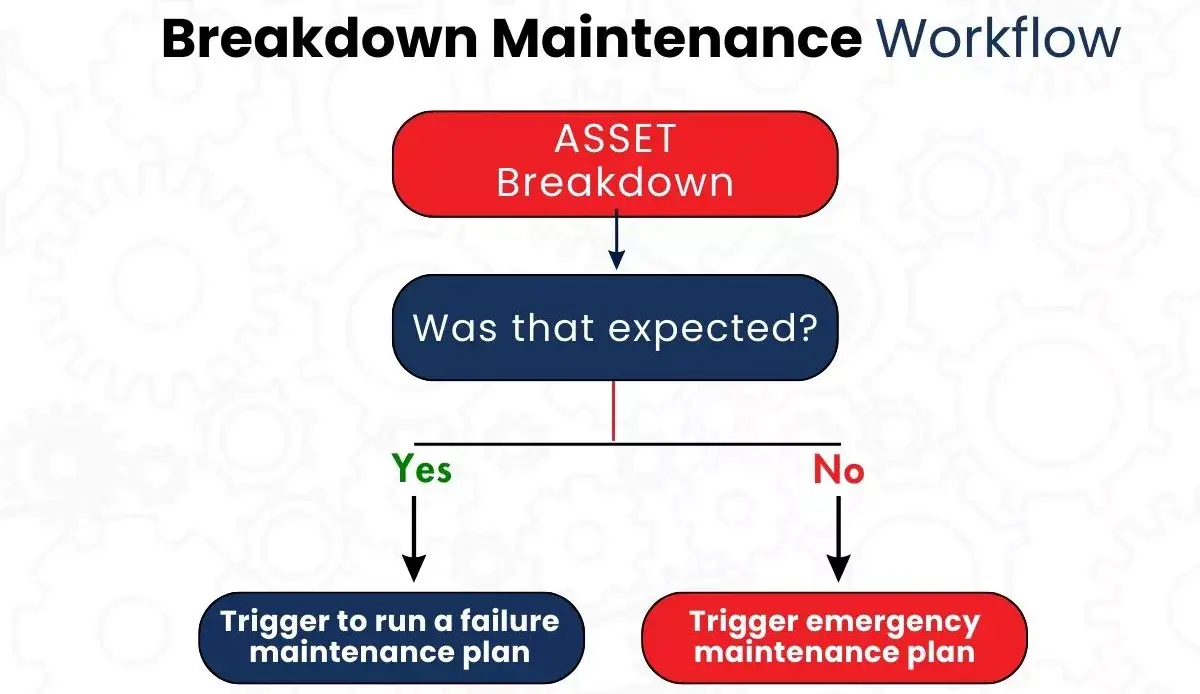

Breakdown maintenance workflow from equipment failure to repair and restart

Types of breakdown maintenance

There are two types. They look the same on the shop floor. They are completely different decisions.

1. Planned breakdown maintenance (run-to-failure)

This is a deliberate choice. You know the equipment will fail one day. You have decided that is acceptable.

What "planned" means here. The failure is not planned. The decision is. The actual failure, and the downtime it causes, can still come at an unexpected time. The plant decides in advance to let the asset run until it fails, and keeps a spare and a quick response ready. This is different from planned corrective work, where a known fault is fixed in a scheduled window.

It works when three things are true.

The equipment is low value. The replacement is available and quick to fit. The failure does not stop production or put anyone at risk.

Light fittings. Small pumps with a standby. Store-room fans. Hand tools. Servicing these costs more than letting them fail.

Run to failure maintenance workflow for low value plant equipment

2. Unplanned breakdown maintenance (emergency response)

This is the one nobody chose.

Critical equipment stops without warning. Production halts. Everything else gets dropped.

Emergency maintenance is expensive for reasons that go well beyond the repair itself.

Work gets done under time pressure, which raises the chance of a second failure. Spares get sourced at rush freight rates. Technicians work overtime. Safety risk rises because people are hurrying.

And the line is not producing while any of this happens.

Emergency maintenance workflow for critical equipment failure in a plant

Two related terms: deferred and opportunity maintenance

You may also hear these two terms. They are scheduling decisions, not separate types of breakdown maintenance.

Deferred maintenance means a known fault is left for later. This usually happens because production cannot stop or the spare is not available. It is fine for a short time. Left too long, it often turns into a breakdown.

Opportunity maintenance means using a stoppage that has already happened to finish other pending jobs on the same machine. If a line is down for a breakdown or a changeover anyway, the team changes that worn belt or leaking hose at the same time.

Breakdown maintenance examples in a plant

Here is how breakdown maintenance looks across common plant equipment.

EquipmentTypical failureResponse
Shop-floor light fittingStops workingPlanned (run-to-failure)
Small coolant pump with a standbyMotor burns outPlanned (run-to-failure)
Store-room exhaust fanBearing wears outPlanned (run-to-failure)
Hand toolsBreak or wear outPlanned (run-to-failure)
Main air compressor (no standby)Trips on high temperatureUnplanned (emergency)
Bottleneck conveyor gearboxBearing seizesUnplanned (emergency)
Hydraulic pressHigh-pressure hose burstsUnplanned (emergency)
CNC machineSpindle drive faultUnplanned (emergency)

The same kind of failure can fall in either column. A seized bearing in a store-room fan is a planned replacement. A seized bearing in a bottleneck conveyor is an emergency. For sector-specific cases, see the top 10 breakdowns in the automotive industry.

Breakdown maintenance procedure: 7 steps

When a machine stops, people should not have to think about what to do first. A simple, written procedure keeps the response safe and quick.

To make each step concrete, we will follow one real-world type of failure. At 2:10 a.m., the gearbox on a bottleneck conveyor seizes. The whole assembly line behind it stops.

1Report the failure
2Make the area safe
3Diagnose the fault
4Plan the repair and get spares
5Carry out the repair
6Test and approve restart
7Record and review

Step 1. Report the failure

The operator stops the machine if it has not stopped already, and informs maintenance straight away. The message should say which machine, what time, and what was seen, heard or smelt.

In our example: the night-shift operator hears a grinding noise, the conveyor stops, and he calls the shift technician with the conveyor number and what he heard.

Step 2. Make the area safe

Before anyone touches the machine, isolate the power, release any stored energy and apply lockout and tagout (LOTO) where required. Keep people away from the area. A rushed repair on a live machine is how a breakdown becomes an injury.

In our example: the technician isolates the drive motor at the motor control panel, puts on his lock and tag, and confirms the conveyor cannot start.

Step 3. Diagnose the fault

Find out what actually failed, not just what stopped. Check the obvious things first: power, fuses, oil levels, loose parts. Then look closer.

In our example: the output shaft bearing in the gearbox has seized. The oil inside is dark and well below the level mark.

Step 4. Plan the repair and get spares

Decide whether to repair or replace, which parts are needed, who will do the work and how long it will take. Tell the production in-charge the expected restart time, so they can plan around it.

In our example: a spare bearing and oil seal are in the store. A spare gearbox is not. The team decides to change the bearing and seal, and estimates three hours.

Step 5. Carry out the repair

Follow the written repair procedure if one exists. Use the correct parts, the correct oil grade and the correct tightening values. Do not take shortcuts because the line is waiting.

In our example: the technician replaces the bearing and seal, checks the coupling alignment, and fills the gearbox with the specified oil to the correct level.

Step 6. Test and approve the restart

Remove locks only when everyone is clear and all guards are back in place. Run the machine empty first. Check noise, temperature and leaks. The production supervisor then approves the restart.

In our example: the conveyor runs empty for 15 minutes with normal noise and temperature. The line is back in production at 6:30 a.m.

Step 7. Record and review

Fill in the breakdown report before the shift ends, while details are fresh. Review it in the next morning meeting. If the same failure has happened before, start a root cause review.

In our example: the report shows this is the second bearing failure on the same gearbox in four months. That triggers a 5 Whys review, which we cover below.

Breakdown report format

A breakdown report does not need to be long. It needs to be filled in every time, in the same way. Here is a simple format, shown with the conveyor example.

FieldWhat to recordExample entry
Asset ID and nameMachine code and descriptionCV-03, assembly line conveyor
Date and timeWhen the failure happened14 March, 2:10 a.m.
Reported by / attended byOperator and technician namesOperator: R. Patil / Technician: S. Das
SymptomsWhat was seen, heard or smeltGrinding noise, then conveyor stopped
Failure categoryMechanical, electrical, hydraulic, pneumatic or otherMechanical
Failure causeWhat failed and why, if knownOutput bearing seized due to low oil level
Repair performedWork done to restore the machineBearing and oil seal replaced, alignment checked, oil topped up
Parts usedSpares and consumables, with quantities1 bearing, 1 oil seal, 4 litres gear oil
DowntimeFrom stop to restart4 hours 20 minutes
Safety checksLOTO applied and removed, guards refittedYes, all guards in place
Restart approved byProduction supervisor nameShift supervisor, 6:30 a.m.
Follow-up actionWhat must happen next, by whom, by whenRepeat failure: 5 Whys review by maintenance head this week

Over a few months, these reports show which machines fail most, which failure categories repeat, and how long repairs take. That is the data behind measures like MTTR and MTBF. Our guide to maintenance KPIs for manufacturing plants explains how to use them.

When breakdown maintenance is the right choice

Three situations where running to failure is the sensible decision.

The equipment is not critical

If equipment failure does not interrupt production and the asset is inexpensive and readily replaceable, run-to-failure may be more economical than scheduled component replacement.

Prevention costs more than repair

Compare the annual cost of servicing against the cost of a failure.

If scheduled maintenance on a component costs more per year than replacing it when it fails, run it to failure.

Failure rate is low and predictable

Some components last for years without attention. Inspecting them monthly wastes technician time that critical equipment needs more.

Sort your equipment into three tiers

The easiest way to decide is to rank every asset once, before anything fails.

TierWhat it meansSuitable for run-to-failure?Examples
Tier 1: CriticalFailure stops production, has no standby, or the parts take long to getNo. Use preventive maintenance and condition checks.Main compressor, bottleneck conveyor, presses, CNC machines
Tier 2: ImportantFailure slows work, but a standby or workaround existsPartly. Maintain key parts, run cheap parts to failure.Standby pumps, secondary conveyors, workshop machines
Tier 3: Non-criticalCheap, quick to replace, no effect on output or safetyYesGeneral lighting, store fans, hand tools

Never run to failure if it affects safety, the environment or the law. Some equipment is cheap but must never be allowed to fail: fire pumps, emergency lighting, safety interlocks, pressure relief valves, lifting equipment, and effluent or pollution control equipment. Their failure can hurt people, harm the environment or break a legal requirement.

Review the tiers at least once a year. A low-risk asset can become critical when a line is rearranged or a standby is removed.

The mistake to avoid. Breakdown maintenance chosen for one machine is strategy. Breakdown maintenance applied to everything because there is no schedule is not a strategy. It is the absence of one.

Advantages and disadvantages of breakdown maintenance

Where it saves money

  • No planning or upfront cost. There is no schedule to build and no routine servicing to pay for.
  • Full use of cheap parts. A part is replaced only when it is worn out, not halfway through its life.
  • Technician time goes where it matters. Less time on low-value assets means more time for critical machines.
  • Suits random failures. Some parts, like electronic cards, fail without warning signs that inspection can catch.

Where it creates risk

  • Lost production. On a critical machine, every hour of downtime is lost output.
  • Higher repair bills. Rush spares, overtime and damage to nearby parts add up quickly.
  • Safety risk. Sudden failures and hurried repairs are when people get hurt.
  • Shorter machine life. One failed part often damages others before the machine stops.
  • Unpredictable budget. Costs arrive whenever something fails, not when they were planned.

The pattern is simple. The advantages apply to Tier 3 equipment. The risks apply to Tier 1.

What a breakdown actually costs

Most plants record the repair cost. The part, the labour, the time on the job card.

That is usually the smallest number involved.

CostUsually tracked?Where it sits
Spare parts and labourYesMaintenance budget
Lost production hoursRarelyProduction
Idle operators during the stoppageRarelyHR and payroll
Rush freight on sparesSometimesLogistics
Overtime to recover scheduleSometimesHR and payroll
Late delivery penaltyRarely linked backSales and commercial
Scrap from an unplanned stopRarelyQuality

The costs sit across five departments. Nobody adds them up.

That is why breakdown maintenance often looks cheaper than it is. A plant maintenance audit is usually the first time these numbers get pulled together.

How to calculate the cost of unplanned downtime

The true cost of a breakdown is more than the repair invoice. To estimate it, add the production contribution lost during the stoppage to the extra labour, repair, logistics, quality and commercial costs you can reasonably measure.

A practical downtime cost formula

Total downtime cost = Lost production contribution + Repair cost + Emergency labour/overtime + Expedited spare-part and logistics costs + Scrap/rework costs + Other measurable commercial losses

Example calculation

Suppose a production line contributes ₹25,000 per hour, and an unexpected equipment failure stops production for 4 hours. Assume the lost output cannot be made up later.

Note: contribution means the sales value of the lost output minus its variable costs, such as raw material and power. It is not the full sales value.

Lost production contribution:

₹25,000 × 4 = ₹1,00,000

If the breakdown also creates:

  • Repair and spare parts: ₹20,000
  • Repair crew overtime: ₹8,000
  • Emergency logistics: ₹5,000
  • Scrap/rework: ₹7,000

Then:

Estimated downtime impact = ₹1,00,000 + ₹20,000 + ₹8,000 + ₹5,000 + ₹7,000 = ₹1,40,000

Avoid double-counting. If the lost output is recovered later through production overtime, count the cost of that overtime, not the lost contribution. Counting both makes the breakdown look more expensive than it was.

These figures are only an illustration. The aim is not a universal downtime rate. It is to help each plant put a number on its own failures, so maintenance decisions can be judged against their true cost.

How to respond faster when equipment fails

You cannot stop every breakdown. You can decide whether it costs two hours or two days. (For ways to reduce how often machines fail in the first place, read our guide on how to minimise breakdowns.)

Rank equipment before anything fails

When two machines are down at once, the team should already know which one gets attention first. The tier table above makes that decision in advance, not during the emergency.

Hold spares for critical equipment

The longest part of most breakdowns is waiting for a part.

Bearings, seals, contactors, drive belts and sensors for critical machines should be on the shelf. Not in a supplier catalogue.

Plan for Indian plant conditions

Some breakdowns in Indian plants follow a pattern. Planning for them shortens the response.

  • Monsoon moisture. Damp panels and motors develop insulation and tracking faults. Check and seal panels before the rains, and keep spare contactors and relays ready.
  • Voltage surges. Spikes and dips damage drives and PLC cards. Fit surge protection, and keep spare cards for drives on critical machines.
  • Imported spares. A part from abroad can take weeks to arrive. List every imported spare for Tier 1 machines, then either stock it or approve a local equivalent in advance.

Write down the repair procedure

If only one technician knows how to change a specific assembly, your response time depends on whether he is on shift. Documented procedures remove that dependency.

Record every failure properly

What failed. Why it failed. What was done. How long it took.

The breakdown report above covers all of this. Without it, you cannot spot patterns, and the same failure keeps coming back.

Find the root cause, not just the fault

A bearing that fails twice in four months is not a bearing problem. Replacing it again solves nothing.

A simple way to find the real cause is the 5 Whys. Keep asking "why" until you reach something you can fix. Here is how it worked for the conveyor gearbox:

  1. Why did the bearing seize? It overheated because lubrication failed.
  2. Why did lubrication fail? The oil level was too low.
  3. Why was the oil low? Oil was leaking from a worn shaft seal.
  4. Why was the leak not noticed? Nobody checked the oil level on this gearbox.
  5. Why was there no check? The gearbox was never added to the maintenance schedule. It was treated as non-critical, even though the conveyor is a bottleneck.

The fix is not another bearing. It is to move the gearbox to Tier 1, add a weekly oil level and leak check, and replace the seal at every bearing change. Our guide to preventive maintenance shows how to build that schedule.

Have trained people available

Response time depends on who is on site when the failure happens. Plants without enough technical cover across shifts often bring in skilled maintenance manpower rather than carry the headcount full time.

Breakdown, corrective and reactive maintenance

These three terms get used interchangeably. They are not the same.

TermMachine statePlanned?
Breakdown maintenanceStopped completelyThe decision can be planned (run-to-failure). The failure is not.
Corrective maintenanceFault found, machine running or stoppedCan be either
Reactive maintenanceStopped or faultyNo

Corrective maintenance is the widest term. It covers any repair carried out after a fault is found, whether the machine is still running or has already stopped. So a breakdown repair is also a form of corrective work.

The useful point is timing. When a fault is found while the machine is still running, you have time to plan the repair into a stoppage window instead of reacting to a stop.

Breakdown maintenance compared to preventive maintenance

Breakdown maintenancePreventive maintenance
When work happensAfter failureOn a schedule
DowntimeUnplannedPlanned
Short-term costLowerHigher
Long-term costHigherLower
Best suited toLow-value, non-critical equipmentCritical production equipment

Most plants need both. The judgement is which equipment goes in which category.

Our guide to preventive maintenance in manufacturing covers how to build the schedule once you have decided. For your most critical machines, condition monitoring can go a step further. See preventive vs predictive maintenance to decide which fits.

Frequently asked questions

What is breakdown maintenance?

Breakdown maintenance is repair work carried out after equipment has already failed. There is no schedule or inspection interval. The machine runs until something stops working, then it gets fixed.

What are the types of breakdown maintenance?

There are two types. Planned breakdown maintenance (run-to-failure) is a deliberate decision to let low-value, non-critical equipment run until it fails. Unplanned breakdown maintenance (emergency response) is the repair of important equipment that stops without warning.

What is an example of breakdown maintenance?

Replacing a failed light fitting in a store room is planned breakdown maintenance. Repairing a seized gearbox on a production conveyor that has stopped the line is unplanned breakdown maintenance.

What is planned breakdown maintenance?

It is a decision made in advance to let a low-value asset run until it fails, with a spare and a quick response ready. The failure is not planned. The decision to allow it is.

Is breakdown maintenance ever the right choice?

Yes. For low-value equipment that is quick to replace and does not stop production, running to failure costs less than maintaining a schedule. It is never the right choice for equipment that affects safety, the environment or legal compliance.

What is the difference between run-to-failure and emergency maintenance?

Run-to-failure is a planned decision to let low-value equipment fail. Emergency maintenance is an unplanned response to a critical machine stopping without warning.

What is the difference between breakdown and corrective maintenance?

Breakdown maintenance is repair after the machine has stopped. Corrective maintenance is the wider term for any repair after a fault is found, whether the machine is still running or has stopped. When the fault is found while the machine is running, the repair can be planned.

Can preventive maintenance eliminate all breakdowns?

No. Preventive maintenance reduces failures caused by wear, dirt and poor lubrication. Some failures are random, such as electronic faults, power surges or material defects. The goal is fewer breakdowns and a faster, safer response to the ones that still happen.

How do you reduce breakdown maintenance?

Move critical equipment onto a preventive schedule, keep spares for critical machines on site, document repair procedures, and investigate root causes rather than just replacing failed parts. Our guide on how to minimise breakdowns covers this in detail.

Why does the same machine keep failing?

Repeat failures usually mean the root cause was never found. A bearing failing repeatedly is often caused by misalignment, contamination or incorrect lubrication rather than the bearing itself. A 5 Whys review usually finds the real cause.

What is the true cost of a breakdown?

The repair cost is usually the smallest part. Lost production, idle operators, rush freight on spares, overtime and scrap from the unplanned stop typically cost more than the part that failed.

Can breakdown maintenance support be outsourced?

Yes. Many plants use a specialist maintenance partner for breakdown response, particularly across night shifts and weekends where in-house technical cover is limited.

Cut your breakdown response time

SGK India provides breakdown support and planned maintenance for manufacturing plants across India.

We handle equipment criticality ranking, spares planning, breakdown response and root cause analysis, with MTTR and MTBF tracked on every contract.

Explore our plant equipment maintenance services
Facebook
Twitter
Email
Print

Leave a Reply

Your email address will not be published. Required fields are marked *

Latest Post

SGK India Engineering Private Limited Company Logo

Get the Right Solution for Your Plant

Tell us about your requirement and our team will get back to you shortly.
